Rope access vs EWP — which to choose.
When does rope access beat an EWP, and when does an EWP beat rope access? Both are right for some scopes and wrong for others — and on most commercial buildings, both methods get used at different stages. Honest tradeoffs from a contractor running both.
Neither method is universally right.
The buyer mistake we see most often on commercial façade work is assuming one method (usually scaffold or EWP) is the default, and only considering rope access as the back-up. The honest answer is method-by-scope: rope wins some, EWP wins others, scaffold wins a third group, and many programmes are best run with a combination. Below is how we make the call.
Where rope is the right method.
- Short-duration, targeted scopes. Defect rectification, water-ingress investigation, sealant works, glass-defect rectification — anywhere the work is in pockets across a large façade rather than blanket coverage.
- Buildings without ground access for an EWP. Tight CBD streets, occupied podium retail, riverfront tower bases, side-of-tower with no laydown — anywhere a boom can't physically deploy or reach.
- Tall buildings beyond practical EWP reach. Beyond about 50–60 m, EWPs become specialist (and expensive). Rope is height-agnostic.
- Occupied buildings that won't accept scaffold or BMU disruption. Residential towers, occupied office, retail-trading podiums — rope keeps the building operational.
- Short-notice or emergency work. Rope crews mobilise in days; EWP hires require ground access permits and laydown coordination.
- Programmes where access cost is a meaningful share of total. EWP rental is expensive on long programmes; rope crews carry their own gear.
Where a boom or scissor is the right method.

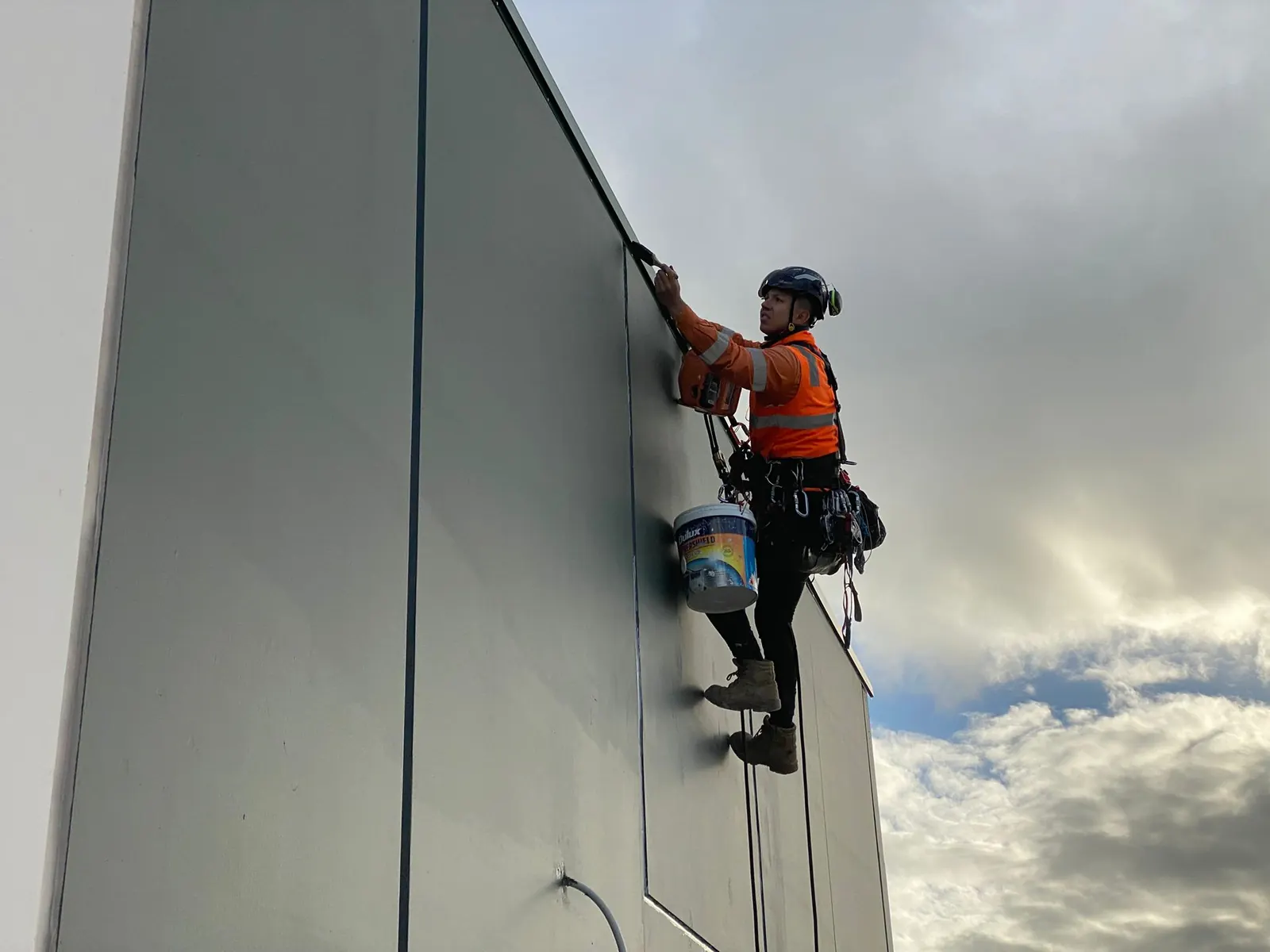

- Continuous, high-volume work across a façade. Painting a tower, washing a façade, blanket inspection — EWP productivity beats rope on sustained linear work.
- Carrying weight that two ropes can't. Heavy plant, large replacement glass panels, structural elements — the EWP basket carries it; a rope crew can't.
- Specifications or builder policy that require EWP. Some Tier 1 builders require EWP for certain scope categories. Some insurance positions favour EWP for specific risk profiles.
- Sites with ample ground access and no occupied-building constraint. If the boom can deploy and the building can accept it, EWP is often the lower-friction option.
- Crews not trained to the two-rope system. EWP operation requires its own ticket (EWP yellow card / WAH licence) but the bar is lower than rope-access training. A general contractor can deploy an EWP scope; rope access requires specialist crews.
Rope access vs EWP — by scope.
Relative cost across common façade and high-access scopes. Real numbers depend on building, height, duration and access — we quote scope-by-scope.
| Scope | Rope access | EWP (boom / scissor) | Which wins |
|---|---|---|---|
| Façade defect survey | Low — crew-days only | Moderate — hire on top of crew | Rope — targeted, no hire cost |
| Spot sealant works (scattered) | Low-moderate | Moderate-high | Rope — scatter favours rope |
| Continuous sealant (one elevation, sustained) | Moderate-high | Moderate | EWP — productivity matches the rental |
| Painting / coatings (1,000+ m²) | High | High — usually edges rope on sustained runs | EWP — sustained linear work suits EWP productivity |
| Glass replacement (heavy panels) | Often impractical (weight limit on rope) | Priced per panel | EWP — the basket carries it; ropes don't |
| Tower above ~50-60m | Same rate as low-rise | Specialist EWPs only; cost climbs steeply | Rope — height-agnostic |
| Emergency response (broken glass, fallen panel) | Low — same-day call-out | Not available inside hours | Rope — only option for genuine emergencies |
| No ground access for boom (tight CBD, occupied podium) | Standard rate | Not feasible | Rope — only option |
EWP scopes carry an equipment-hire line on top of crew and mobilisation, and specialist booms (above 50m reach) hire at a steep premium. Rope access carries no equipment-hire line — only crew day rate and consumables.
Most real programmes use both.
On larger commercial scopes we typically run a combination. The pattern looks like this:
- Diagnostic phase — rope. Pinpoint defects across the building cheaply and quickly. EWP for diagnostic at scale is overkill.
- High-volume rectification — EWP or BMU. Once defects are mapped and remedial is sustained at one elevation, the productivity case shifts.
- Hard-to-reach or scattered remedial — rope. Anything the boom can't reach or any defects scattered enough that EWP reposition cost outweighs productivity.
- Final inspection — rope. Quick, targeted defect close-out.
We're set up to run all three methods (rope, EWP, BMU) with the same trade-qualified crews — see our façade access systems service for detail.
Where the dollars actually land.
Rough relative cost — read these as orders of magnitude, not as a quote:
- Rope access: Day rate per crew. No equipment rental beyond consumables. Mobilisation cost low. Scales linearly with crew count.
- EWP: Day rate per crew plus EWP hire (often the larger share). Mobilisation cost moderate (transport, ground-access setup). Scales with EWP size category — small scissor lifts are cheap, large articulated booms are not.
- Scaffold: Significant fixed cost (erection + dismantle) plus duration-based rental. Mobilisation slow (days to weeks). Only economical for very sustained work or where rope and EWP can't reach.
Rough rule: short programmes favour rope, long sustained programmes favour EWP or scaffold, and most real jobs land somewhere on the mix.
Services on this page.
Common questions.
Is rope access cheaper than EWP?
On short, targeted scopes — typically yes. On long, sustained, high-volume work at one elevation — no, EWP usually wins. The honest answer is scope-by-scope; we'll talk you through the comparison for your building.
Can you do both rope and EWP on the same programme?
Yes — we run both with the same trade-qualified crews. Most larger commercial programmes use a combination. See our façade access systems service for detail.
Does rope access need a building anchor system installed?
For scoped work, yes — either an existing anchor system or rigged anchors installed for the scope. We design, install and certify anchor systems where they're missing — see height-safety systems.
What height can you reach with EWP vs rope?
EWP — practically limited to about 50–60 m of reach for typical large booms; specialist machines reach further but become rare and expensive. Rope is essentially height-agnostic up to building roofline.
Is rope access more dangerous than EWP?
Both are tightly regulated and well-controlled methods. Rope access has a strong safety record under the two-rope system and runs two independent ropes with a rescue plan on every site. EWP has its own risk profile around boom collapse, electrocution and traffic interaction. Method choice should turn on suitability and cost, not safety assumed.
